Page 7 - Sept-Oct2023 Vol 41 No 3
P. 7

•  Advance warning signs for the double   Bank with an appropriate Work Zone   of nearby Signal Mountain. Hopper
           S-curve and intersection          Control Plan and made arrangements   speedily dispatched a two-man crew with
         •  Other advisory warning strategies, such   with Huang and his UTK graduate   a truck and coring rig to Red Bank, and
           as rumble strips prior to the speed limit   student research contingent.  the coring process ensued.
           decrease                            On June 15, MTAS, CTR, and CEE      After processing the collected data and
         •  Field checking chord distances in the   team members arrived to find the   performing lab tests on the core samples,
           curve itself                      temporary traffic control plan in place and   UTK’s Dr. Yeutan Ma shared a report
         Other Factors Under Consideration   police traffic control support standing by.  with MTAS and CTR confirming their
           MTAS Public Works Consultant John   On that particular date, Red Bank had   initial suspicions. The pavement surface
         Chlarson, P.E. and CTR’s Matt Cate, P.E.,   no access to a coring rig for collection   in question did, indeed, have a surface
         Director of the Tennessee Transportation   of asphalt pavement core samples, but   friction or skid resistance that was lower
         Assistance Program, (TTAP), concurred   Chlarson asked for assistance from   than desirable.
         that sight distance was adequate for the   Loretta Hopper, Public Works Director              Continued on page 8
         posted speed and that collected speed
         data did not show speeds typically
         exceeding the sight distance for safe
         stopping.
           Accident reports and personal
         inclement field weather observations led
         the team to believe the surface friction
         of the subject road segment might be the
         culprit, i.e., something changed when the
         road was resurfaced. However, the team
         wanted something more than instinct to
         verify the diagnosis before recommending
         possible solutions at Red Bank’s expense.
         Surface Friction Tests Recommended
           Chlarson, Cate and Brad Peters of
         MTAS had discussions with Red Bank
         staff including Seymour and Red Bank’s
         Public Works Director Gregory Tate, then

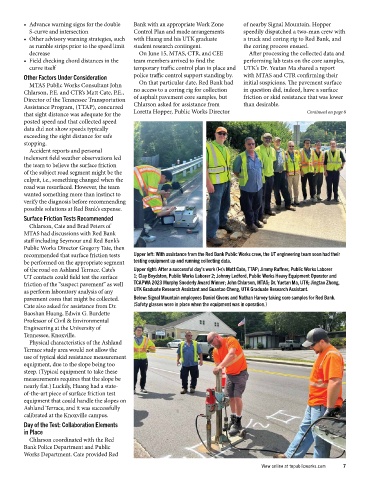

         recommended that surface friction tests   Upper left: With assistance from the Red Bank Public Works crew, the UT engineering team soon had their
         be performed on the appropriate segment   testing equipment up and running collecting data.
         of the road on Ashland Terrace. Cate’s   Upper right: After a successful day’s work (l-r): Matt Cate, TTAP; Jimmy Ruffner, Public Works Laborer
         UT contacts could field test the surface   1; Clay Boydston, Public Works Laborer 2; Johnny Ledford, Public Works Heavy Equipment Operator and
         friction of the “suspect pavement” as well   TCAPWA 2023 Murphy Snoderly Award Winner; John Chlarson, MTAS; Dr. Yuetan Ma, UTK; Jingtao Zhong,
         as perform laboratory analysis of any   UTK Graduate Research Assistant and Guantao Cheng, UTK Graduate Research Assistant.
         pavement cores that might be collected.   Below: Signal Mountain employees Daniel Givens and Nathan Harvey taking core samples for Red Bank.
         Cate also asked for assistance from Dr.   (Safety glasses were in place when the equipment was in operation.)
         Baoshan Huang, Edwin G. Burdette
         Professor of Civil & Environmental
         Engineering at the University of
         Tennessee, Knoxville.
           Physical characteristics of the Ashland
         Terrace study area would not allow the
         use of typical skid resistance measurement
         equipment, due to the slope being too
         steep. (Typical equipment to take these
         measurements requires that the slope be
         nearly flat.) Luckily, Huang had a state-
         of-the-art piece of surface friction test
         equipment that could handle the slopes on
         Ashland Terrace, and it was successfully
         calibrated at the Knoxville campus.
         Day of the Test: Collaboration Elements
         in Place
           Chlarson coordinated with the Red
         Bank Police Department and Public
         Works Department. Cate provided Red

                                                                                        View online at tnpublicworks.com   7
